Restoring access - Eurobodalla Valley bridges
The Eurobodalla Valley was isolated after the 2019 New Year's Eve bushfires destroyed four timber bridges and damaged another four. Our teams were soon out on Eurobodalla Road and on to Cadgee and Nerrigundah assessing the damage and restoring access.
Three of the bridges simply required repairs to the timber decks to get vehicles crossing safely again. Others took a lot more work. Our crews worked quickly to create temporary side tracks around the destroyed bridges.
Transport for NSW agreed to replace many of the bridges using more resilient InQuik Bridging Systems. The semi-modular steel and concrete bridging systems reduce project cost and complexity and are relatively quick to install.
We have now rebuilt all of the bridges with permanent, fire and flood resilient concrete structures.
Check out the progress of each bridge.
Cheese Factory Bridge
Current status: Permanent access restored

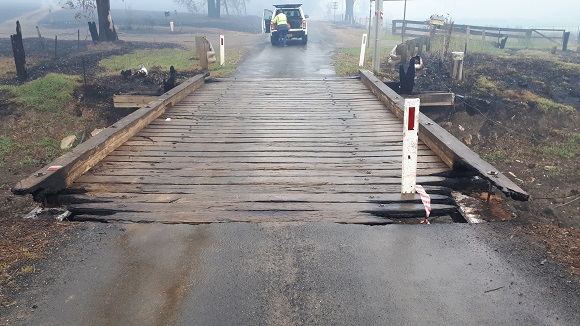

The damage: Some deck timbers burnt
The work: Our bridge crew removed and replaced the burnt timbers to enable safe passage. We then replaced the bridge using the InQuik Bridging System.

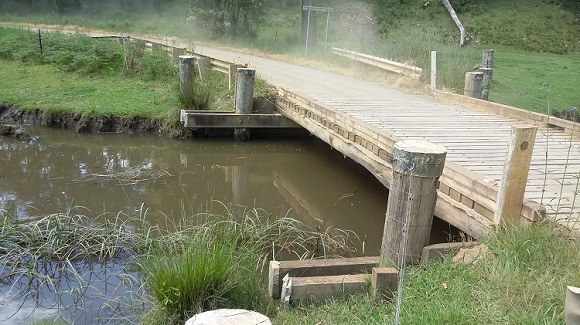

Pre-fire: The single span bridge before the fire
January 2020: The deck timbers were burnt in the 31 December bushfire

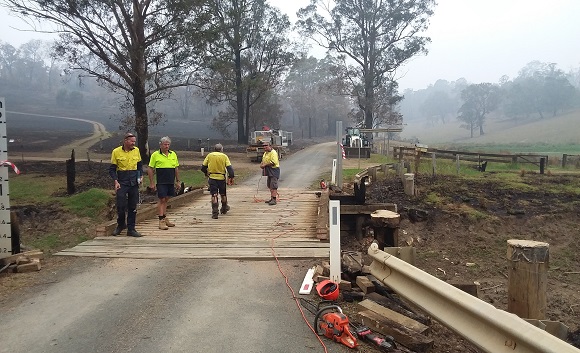

January 2020: Repair work was soon underway
January 2020: Safe access restored

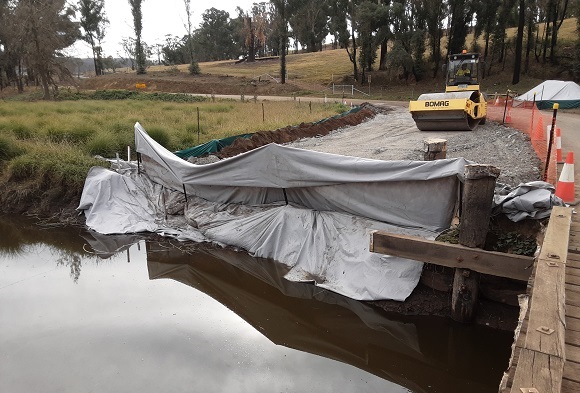

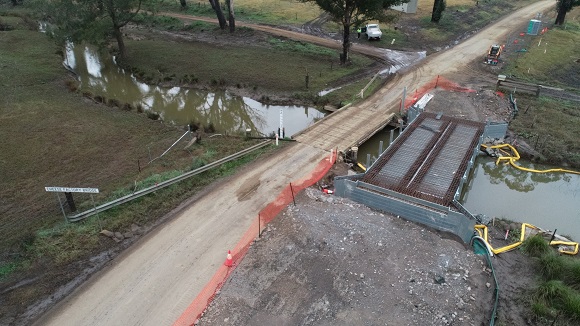

July 2020: Work begins on the approach for the new bridge
August 2020: The InQuik bridge components have been craned into place

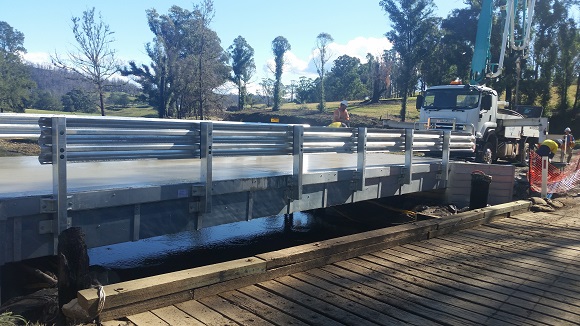

August 2020: The concrete is poured, forming the new bridge surface

October 2020: The new bridge was opened to traffic on 6 October

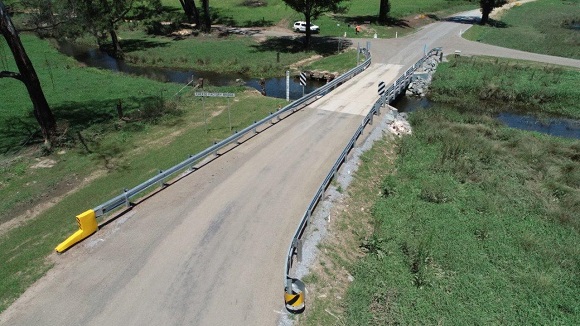

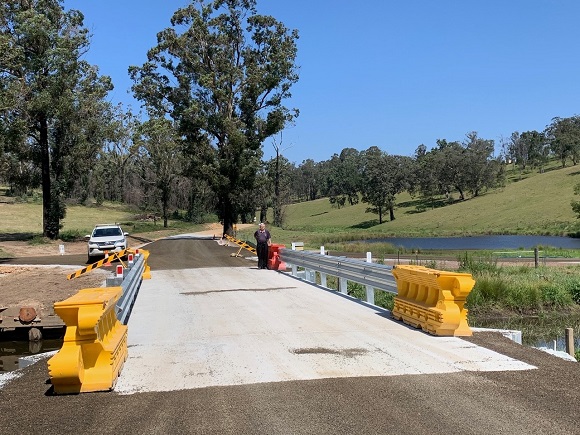

November 2020: Guardrail lines the finished InQuik bridge
Previous
Next
Pre-fire: The single span bridge before the fire
January 2020: The deck timbers were burnt in the 31 December bushfire
January 2020: Repair work was soon underway
January 2020: Safe access restored
July 2020: Work begins on the approach for the new bridge
August 2020: The InQuik bridge components have been craned into place
August 2020: The concrete is poured, forming the new bridge surface
October 2020: The new bridge was opened to traffic on 6 October
November 2020: Guardrail lines the finished InQuik bridge
Previous
Next
Reedy Creek Bridge
Current status: Permanent access restored
The damage: Completely destroyed
The work: We created a side track until the bridge was replaced using the InQuik Bridging System.

Pre-fire: The timber bridge was surrounded by foliage

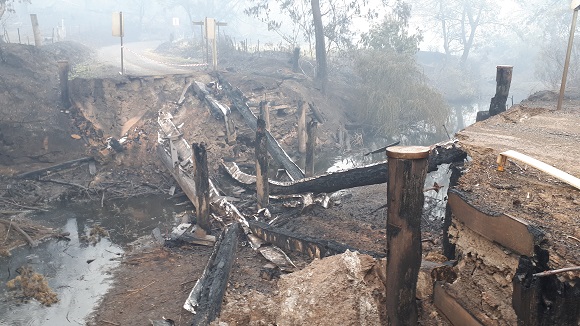

January 2020: The fire totally destroyed the bridge leaving a gaping hole in the road
February 2020: Flood waters destroyed a temporary crossing built in January

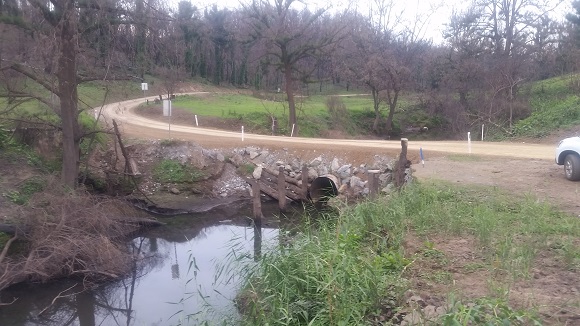

March 2020: A more substantial side track provides access until the bridge is replaced

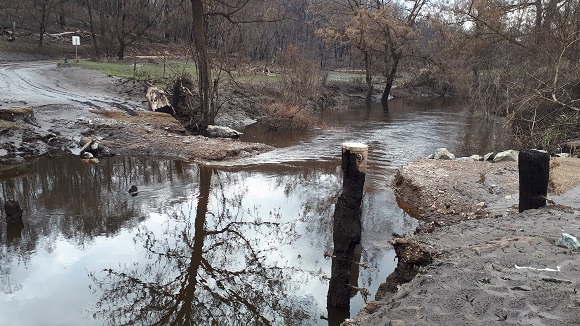

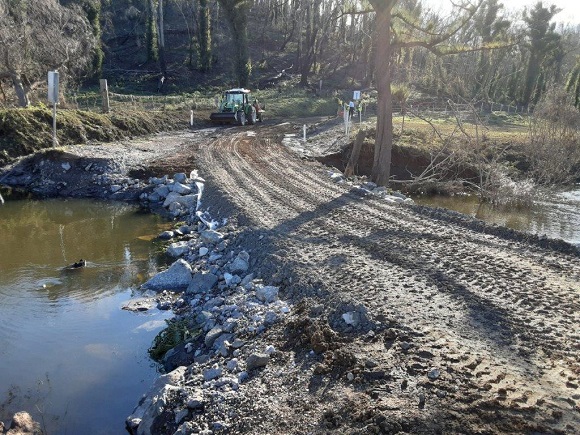

July 2020: The crossing copped a battering from flood waters but was soon restored

November 2020: Construction of the new bridge is underway with the abutments in place and formwork prepped for the deck

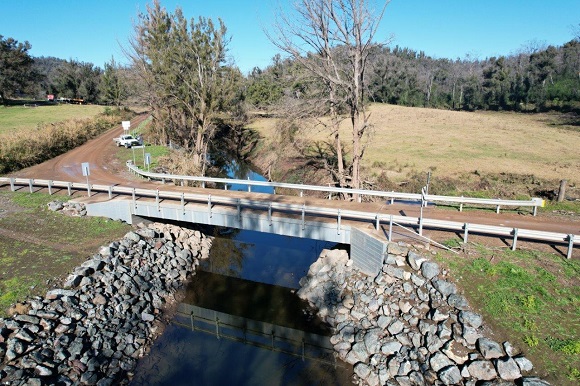

January 2021: The new bridge is open to traffic
The final product: Guardrail lines the modular bridge providing the finishing touch
Previous
Next
Pre-fire: The timber bridge was surrounded by foliage
January 2020: The fire totally destroyed the bridge leaving a gaping hole in the road
February 2020: Flood waters destroyed a temporary crossing built in January
March 2020: A more substantial side track provides access until the bridge is replaced
July 2020: The crossing copped a battering from flood waters but was soon restored
November 2020: Construction of the new bridge is underway with the abutments in place and formwork prepped for the deck
January 2021: The new bridge is open to traffic
The final product: Guardrail lines the modular bridge providing the finishing touch
Previous
Next
Peach Tree Bridge
Current status: Permanent access restored
The damage: Completely destroyed
The work: We created a side track to provide access until the bridge was replaced using the InQuik Bridging System

Pre-fire: The timber bridge nestled into the bushland

January 2020: The damaged bridge.
March 2020: A temporary side track provides access

November 2020: Construction of the new bridge is underway and a section of the new deck is lowered into place

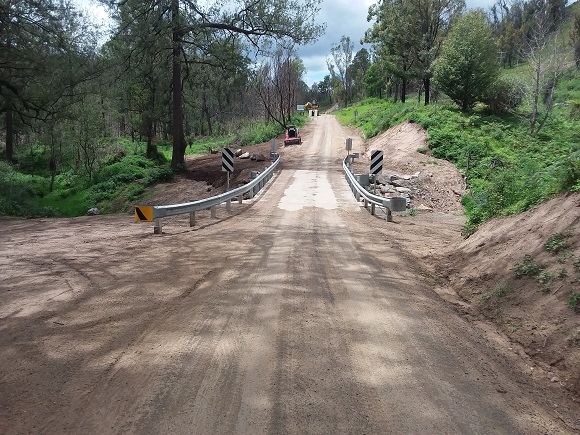

February 2021: The new bridge is open!
Previous
Next
Pre-fire: The timber bridge nestled into the bushland
January 2020: The damaged bridge.

March 2020: A temporary side track provides access
November 2020: Construction of the new bridge is underway and a section of the new deck is lowered into place
February 2021: The new bridge is open!
Previous
Next
Murphys Bridge
Current status: Permanent access restored
The damage: The majority of the bridge was destroyed
The work: We initially established a side track, but it soon washed away in flood waters. Construction of a more resilient concrete bridge started in October 2021 funded through the Natural Disaster Relief and Recovery Arrangements. Wet weather and continuing high river flows hindered progress. Access was restored for the local community in August 2022 and the bridge was finished soon after.

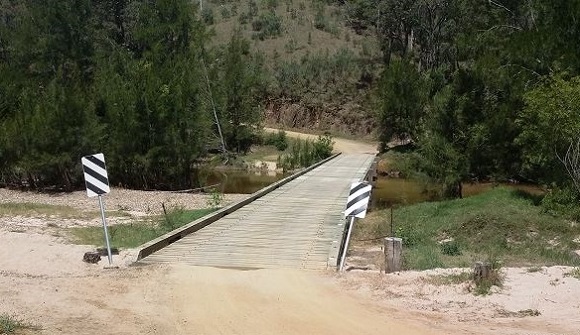

Pre-fire: The bridge sat solidly above the Tuross River

January 2020: Not much was left of the bridge, but at least the lack of rain allowed vehicles to pass
Late-January 2020: A side track was strengthened with large steel pipes and gravel so vehicles could pass through
March 2020: Heavy rain and flood waters in February washed away the temporary track
August 2021: Components of the new bridge have been prefabricated and are on their way to site
November 2021: A huge a drill rig installs the foundations for the new bridge
February 2022: After a brief opportunity to continue the rebuild, the river flooded
June 2022: The rain eased up just enough to allow the contractor to get back on the job in May. By the end of June the foundations were in place.
August 2022: The concrete is laid to form the new bridge deck

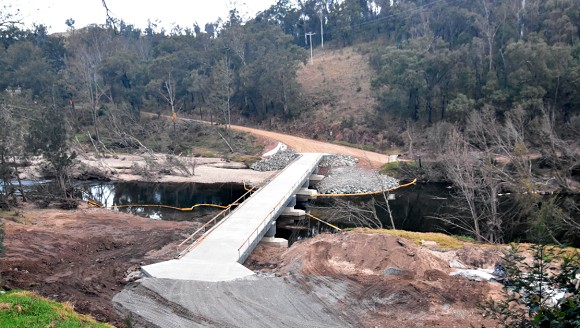

Late August 2022: The concrete approaches are built and local residents can use the bridge!
Previous
Next
Pre-fire: The bridge sat solidly above the Tuross River
January 2020: Not much was left of the bridge, but at least the lack of rain allowed vehicles to pass
Late-January 2020: A side track was strengthened with large steel pipes and gravel so vehicles could pass through
March 2020: Heavy rain and flood waters in February washed away the temporary track

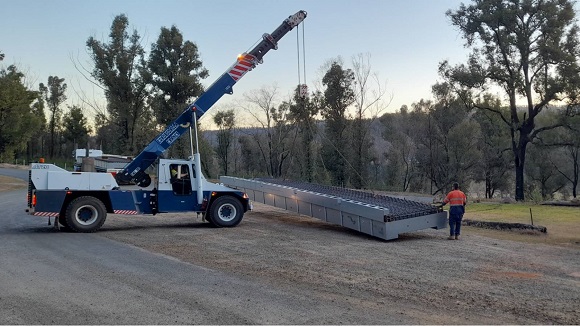

August 2021: Components of the new bridge have been prefabricated and are on their way to site

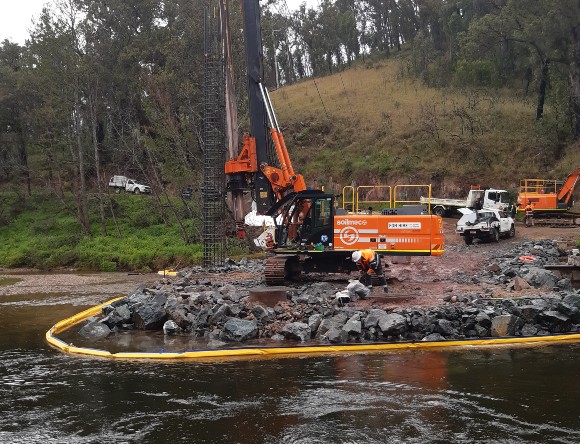

November 2021: A huge a drill rig installs the foundations for the new bridge

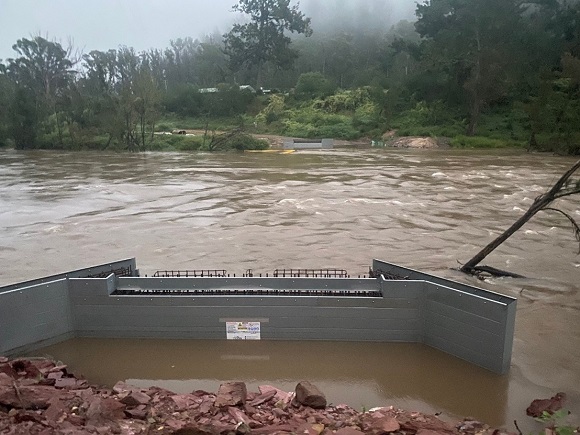

February 2022: After a brief opportunity to continue the rebuild, the river flooded

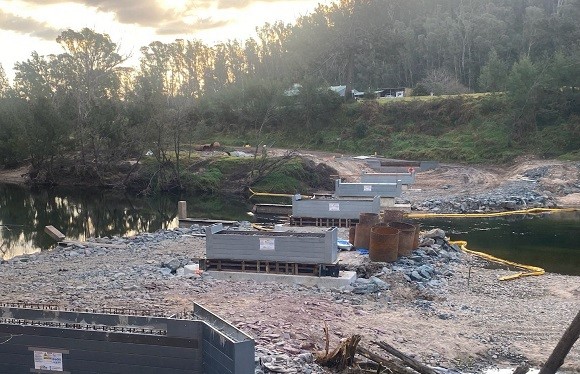

June 2022: The rain eased up just enough to allow the contractor to get back on the job in May. By the end of June the foundations were in place.
August 2022: The concrete is laid to form the new bridge deck
Late August 2022: The concrete approaches are built and local residents can use the bridge!
Previous
Next
Sinclairs Bridge
Current status: Permanent access restored
The damage: Partly destroyed
The work: We replaced the bridge using an InQuik Bridging System

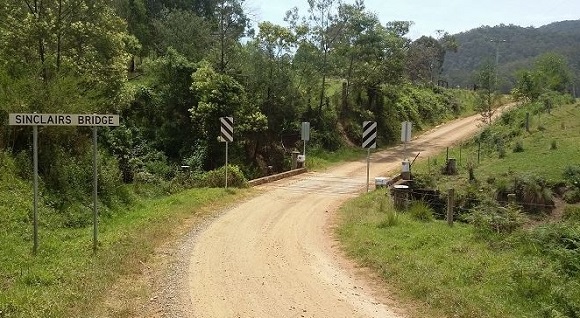

Pre-fire: The single span bridge in lush farmland

January 2020: The damage was relatively minor in comparison to the other bridges

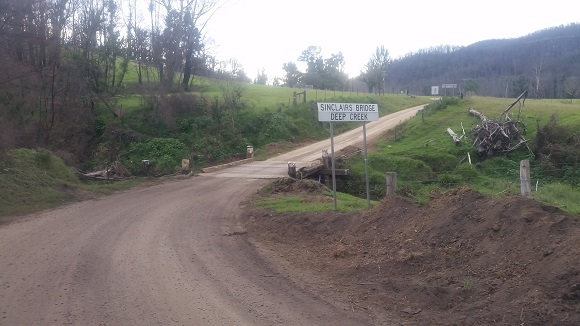

May 2020: The repaired bridge leads commuters into the green farmland beyond

July 2020: Construction of the new bridge is underway
August 2020: The new abutments are in place either side of the creek

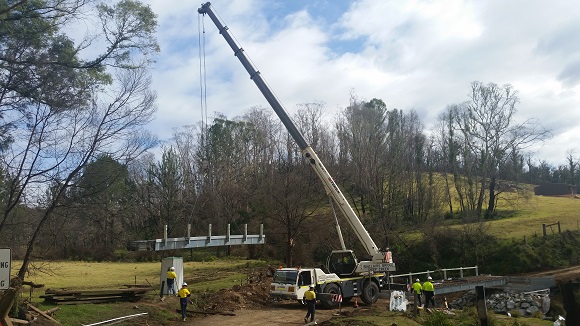

August 2020: The new InQuik bridge components are craned into position

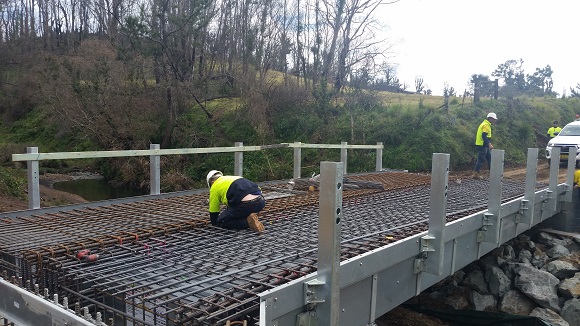

August 2020: Steel reinforcing mesh is prepped for the concrete pour

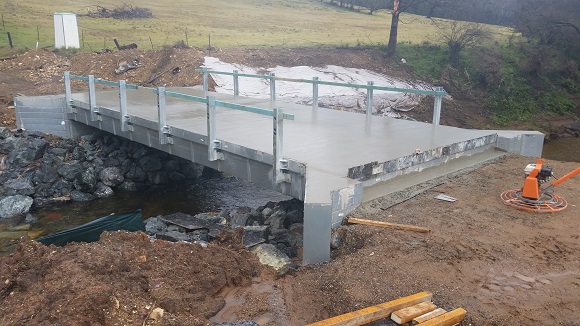

August 2020: Concrete provides a finished surface for the new bridge
August 2020: The new bridge is finished and opened to traffic on 28 August

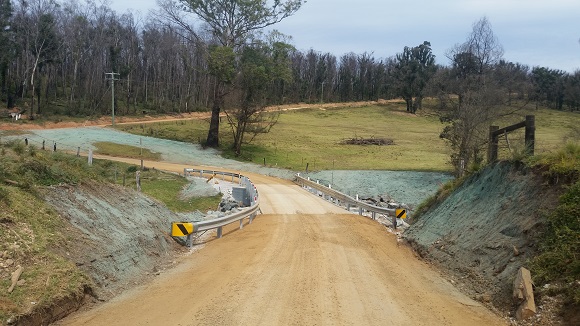

October 2020: Warm Spring weather has enabled the grass to take hold
Previous
Next
Pre-fire: The single span bridge in lush farmland
January 2020: The damage was relatively minor in comparison to the other bridges

May 2020: The repaired bridge leads commuters into the green farmland beyond
July 2020: Construction of the new bridge is underway
August 2020: The new abutments are in place either side of the creek
August 2020: The new InQuik bridge components are craned into position
August 2020: Steel reinforcing mesh is prepped for the concrete pour
August 2020: Concrete provides a finished surface for the new bridge
August 2020: The new bridge is finished and opened to traffic on 28 August
October 2020: Warm Spring weather has enabled the grass to take hold
Previous
Next
Gulph Creek Bridge
Current status: Permanent access restored
The damage: Most of the deck timbers were burnt
The work: We removed and replaced the kerb logs and deck timbers, then replaced the bridge using the InQuik Bridging System

Pre-fire: The bridge typically sat in a lush bushy setting

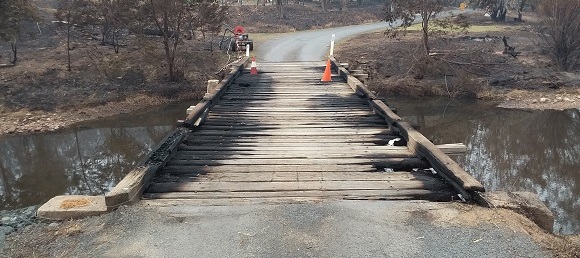

January 2020: Most of the deck timbers were burnt
January 2020: Our bridge crew was quick to replace the burnt supporting girders and deck timbers
Mid-January 2020: The bridge looks new albeit in an altered setting

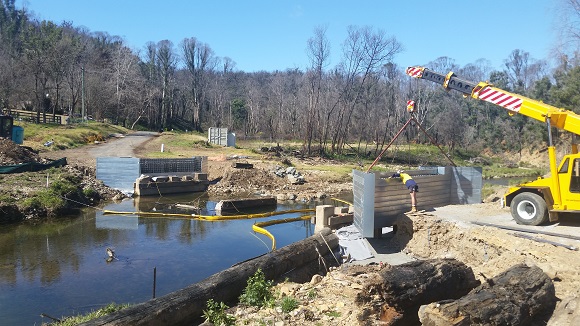

August 2020: The old bridge has been demolished and the new abutments are in place
October 2020: Reinforcement for the concrete deck is prepared

October 2020: A boom pumps concrete into the bridge formwork

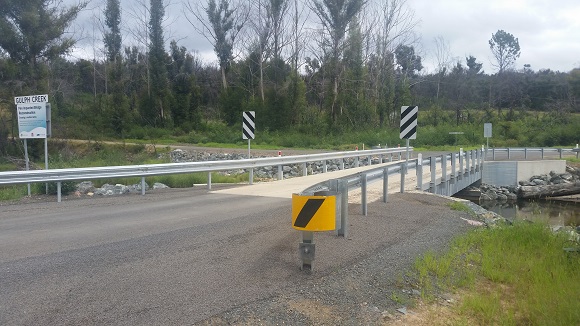

November 2020: The bridge was open to traffic in November 2020
Previous
Next
Pre-fire: The bridge typically sat in a lush bushy setting
January 2020: Most of the deck timbers were burnt
January 2020: Our bridge crew was quick to replace the burnt supporting girders and deck timbers
Mid-January 2020: The bridge looks new albeit in an altered setting
August 2020: The old bridge has been demolished and the new abutments are in place

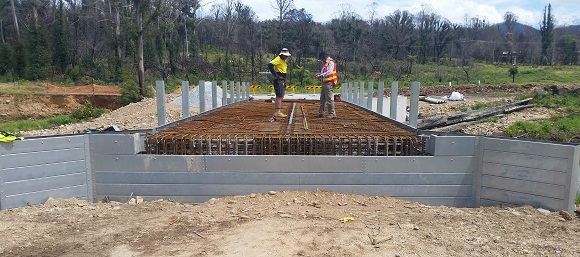

October 2020: Reinforcement for the concrete deck is prepared
October 2020: A boom pumps concrete into the bridge formwork
November 2020: The bridge was open to traffic in November 2020
Previous
Next
Comans Bridge
Current status: Permanent access restored
The damage: Completely destroyed
The work: We created a side track until the bridge was replaced with box culverts

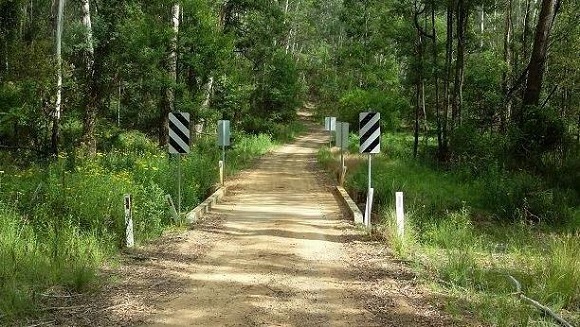

Pre-fire: The single span timber bridge originally sat in a lush setting

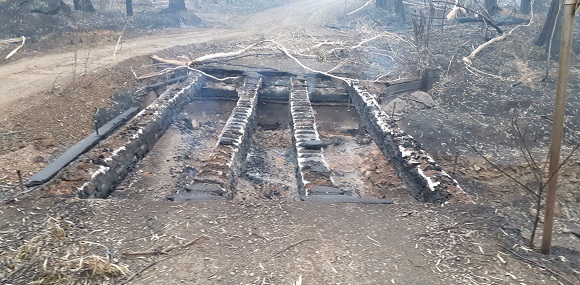

January 2020: Fire destroyed the entire timber deck and a side track was established

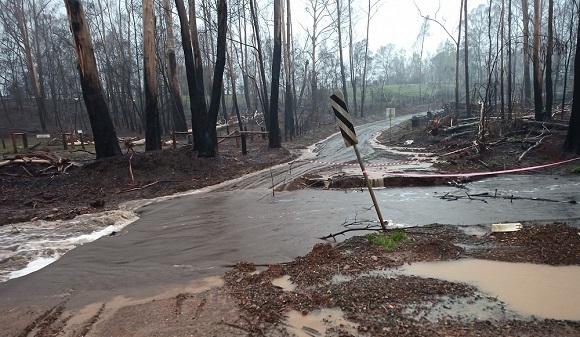

Early February 2020: Rising flood waters blocked access

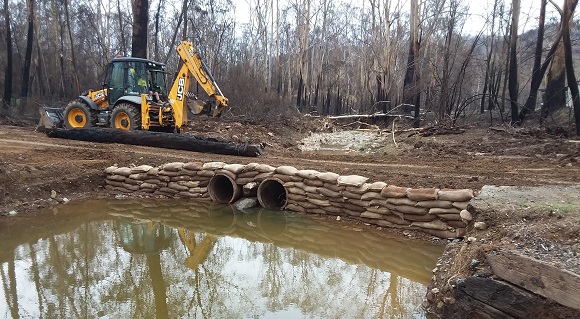

Mid-February 2020: A more durable side track was constructed after the flood

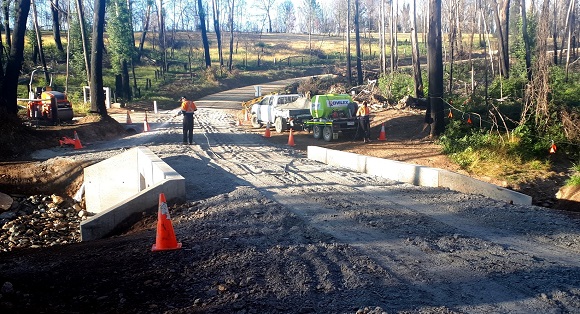

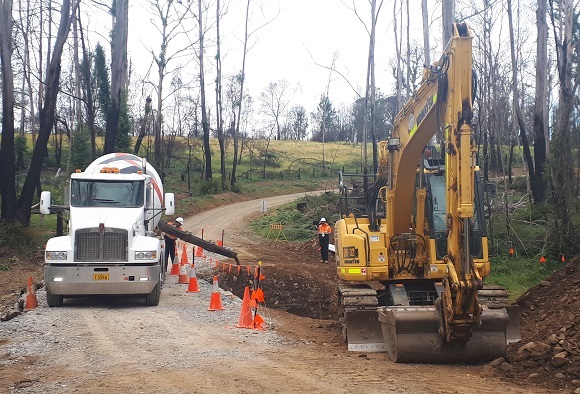

May 2020: Work to build the box culverts is underway and a concrete base is being formed
June 2020: The side track has been removed, and the culverts are in place

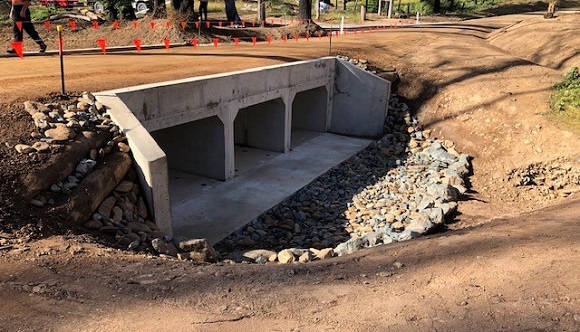

June 2020: Box culverts support the gravel road and access is restored on 29 June
The finished product: The guardrail lines the road through the recovering forest
Previous
Next
Pre-fire: The single span timber bridge originally sat in a lush setting
January 2020: Fire destroyed the entire timber deck and a side track was established
Early February 2020: Rising flood waters blocked access
Mid-February 2020: A more durable side track was constructed after the flood
May 2020: Work to build the box culverts is underway and a concrete base is being formed
June 2020: The side track has been removed, and the culverts are in place
June 2020: Box culverts support the gravel road and access is restored on 29 June
The finished product: The guardrail lines the road through the recovering forest
Previous
Next
Clarksons Bridge
Current status: Open
The damage: Some deck timbers and structural timbers were burnt
The work: Our engineers assessed the damage and the burnt deck timbers were replaced.
The plan: Monitor the bridge regularly until it is replaced using funding from The Fixing Bridges program.

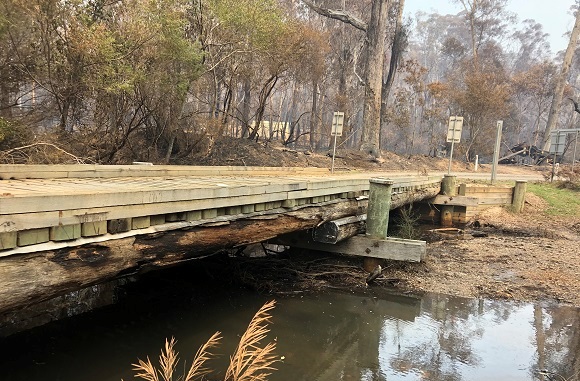

January 2020: Fortunately the bridge survived the fire
January 2020: Fortunately the bridge survived the fire
Previous
Next
Other areas
More info
For more information about restoring access, please contact Council:
