Restoring access - Belowra Valley bridges

The Belowra community was left isolated after the 2019 New Year’s Eve bushfires destroyed four crucial timber bridges.
Our teams were soon on the scene to assess the damage and arrange temporary crossings.
All four bridges have now been replaced with permanent structures that are more fire and flood resilient. Given the scale of the damage, we relied on financial assistance from the NSW and Federal governments' Natural Disaster Relief and Recovery Arrangements to get the job done.

Belimbla Bridge
The damage: Completely destroyed
Current status: Permanent access restored
The work: We initially established a side track, which was washed away by flood waters. We then created a temporary bridge to maintain access until the bridge was replaced using the InQuik Bridging System.

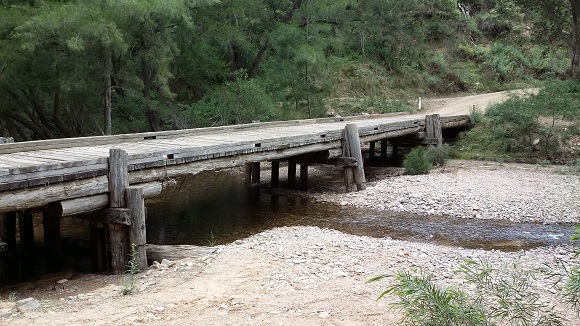

 Pre-fire: The multi-span bridge before the bushfire

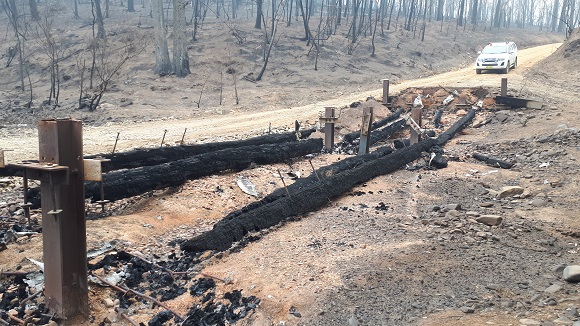

 January 2020: After the 31 December bushfire

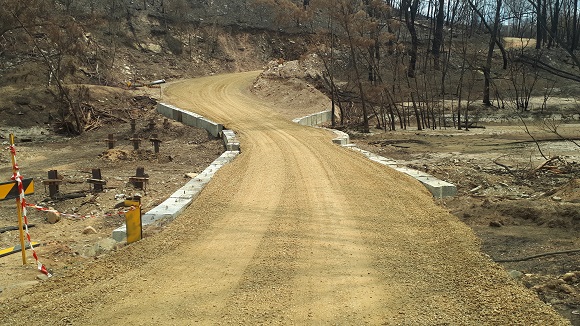

 January 2020: A side track was quickly established to a allow temporary access

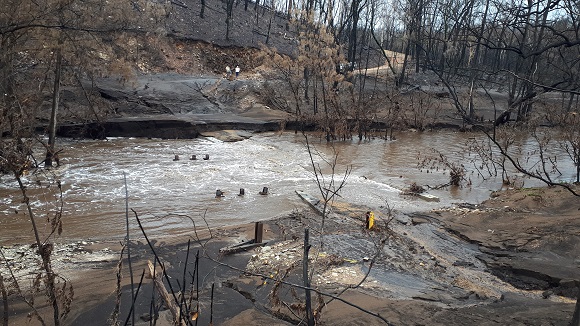

 February 2020: Flood waters swept away the temporary track after heavy rain

 March 2020: Progress was underway with the more resilient temporary timber bridge

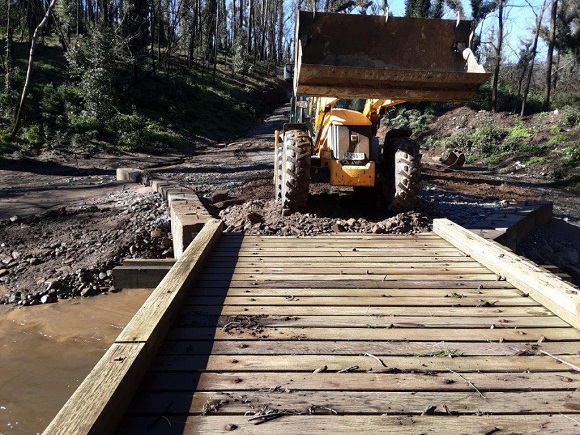

 July 2020: Flood waters wreaked havoc on the road approaching the temporary bridge

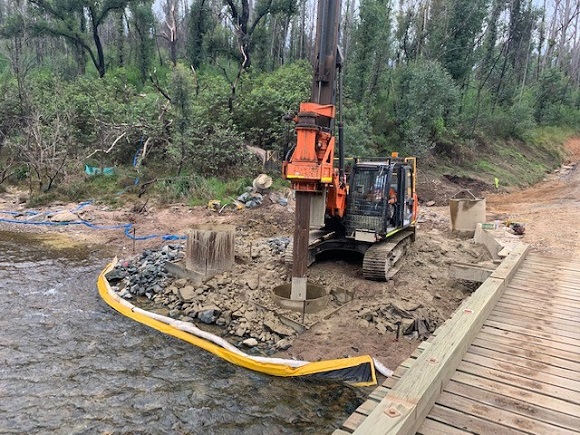

 April 2021: A drill rig preps the site for the new bridge piles

 June 2021: Formwork for new deck shows the height of the new bridge

 July 2021: Traffic is directed off the temporary timber bridge and on to the new bridge

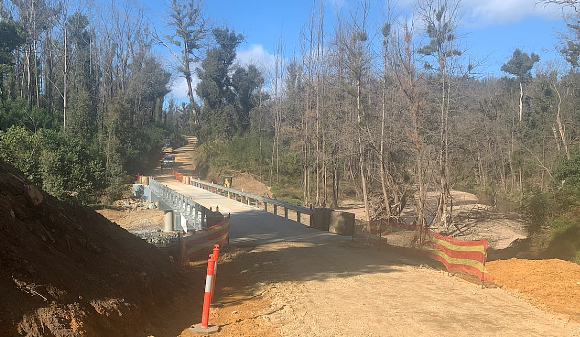

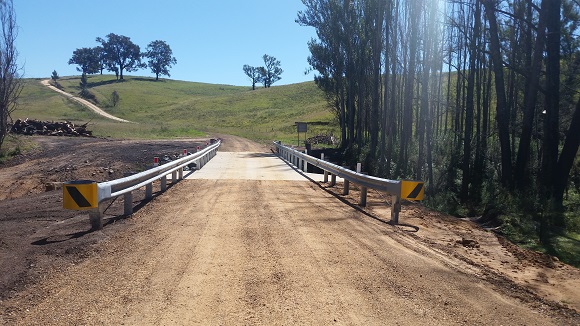

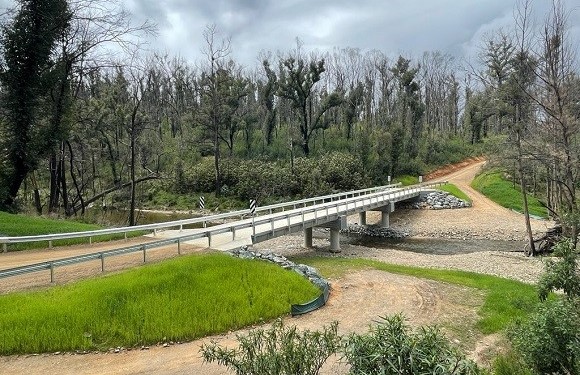

 October 2021: The finished product

                    Previous

                    Next

 Pre-fire: The multi-span bridge before the bushfire

 January 2020: After the 31 December bushfire

 January 2020: A side track was quickly established to a allow temporary access

 February 2020: Flood waters swept away the temporary track after heavy rain

 March 2020: Progress was underway with the more resilient temporary timber bridge

 July 2020: Flood waters wreaked havoc on the road approaching the temporary bridge

 April 2021: A drill rig preps the site for the new bridge piles

 June 2021: Formwork for new deck shows the height of the new bridge

 July 2021: Traffic is directed off the temporary timber bridge and on to the new bridge

 October 2021: The finished product

                                            Previous

                                            Next

Belowra Bridge
The damage: Completely destroyed
Current status: Permanent access restored
The work: We created an initial side track (then recreated the track after it was washed away) to maintain access until the bridge was replaced using the InQuik Bridging System.

 Pre-fire: The picturesque timber bridge amid the she oak trees

 January 2020: A sudden drop where the bridge used to be

 January 2020: Little remains of the old timber bridge

 March 2020: The temporary fix provides access again

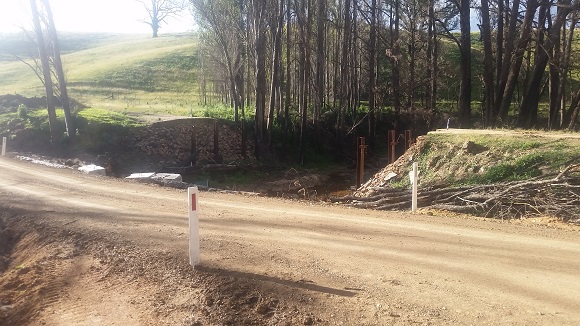

 May 2020: The side track sits adjacent to the ruins of the old bridge

 July 2020: Flood waters ripped through the temporary side track

 July 2020: The temporary crossing is restored after the flood

 February 2021: The new bridge structure is in place awaiting a road surface

                    Previous

                    Next

 Pre-fire: The picturesque timber bridge amid the she oak trees

 January 2020: A sudden drop where the bridge used to be

 January 2020: Little remains of the old timber bridge

 March 2020: The temporary fix provides access again

 May 2020: The side track sits adjacent to the ruins of the old bridge

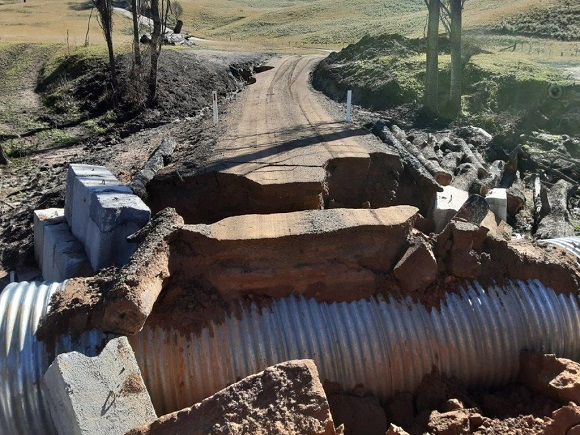

 July 2020: Flood waters ripped through the temporary side track

 July 2020: The temporary crossing is restored after the flood

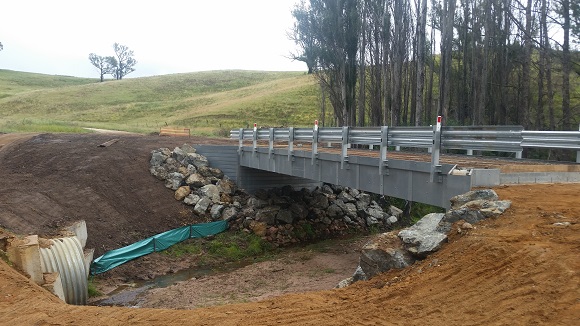

 February 2021: The new bridge structure is in place awaiting a road surface

                                            Previous

                                            Next

Four Gums Bridge
The damage: Completely destroyed
Current status: Permanent access restored
The work: We established a temporary side track before replacing the bridge with a concrete structure

 Pre-fire: The single-span bridge before the bushfire

 January 2020: The damage

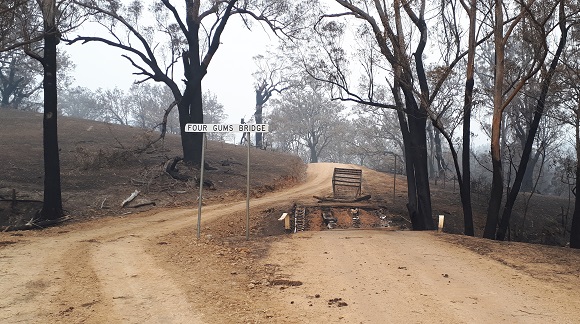

 January 2020: A dirt side track provides access around the bridge

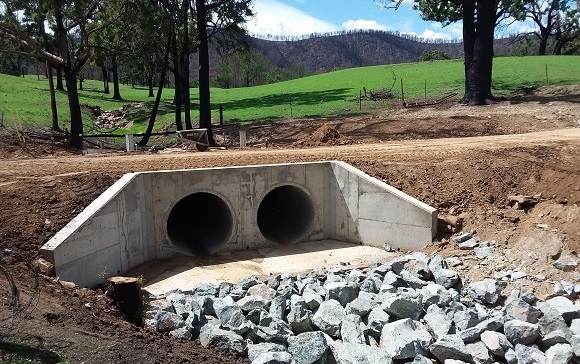

 February 2020: The permanent replacement opened the road on 26 February

                    Previous

                    Next

 Pre-fire: The single-span bridge before the bushfire

 January 2020: The damage

 January 2020: A dirt side track provides access around the bridge

 February 2020: The permanent replacement opened the road on 26 February

                                            Previous

                                            Next

Sitters Ditch Bridge
The damage: Completely destroyed
Current status: Permanent access restored
The work: We established a temporary side track before replacing the bridge with triple cell piped culverts

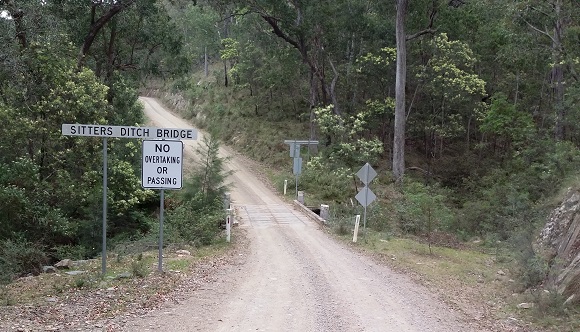

 Pre-fire: The bridge sat in a lush forest

 January 2020: The bridge abutment walls no longer exist and little is left of the deck

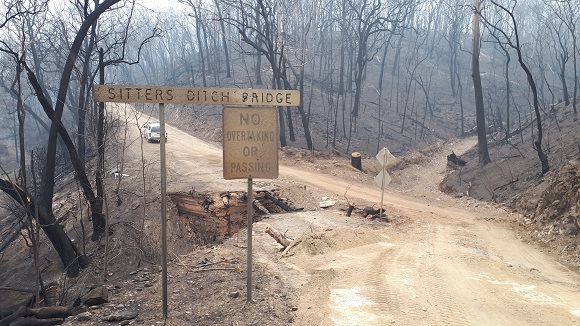

 January 2020: A temporary track winds around the burnt out bridge

 May 2020: The temporary side track was washed away by flood waters and later rebuilt

 March 2021: Gabion baskets are installed for the water spillway downhill from the bridge

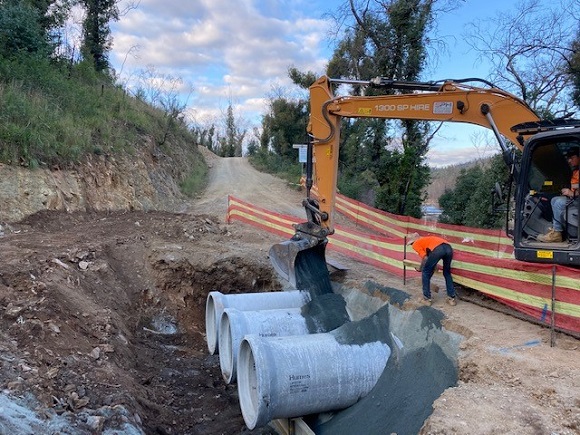

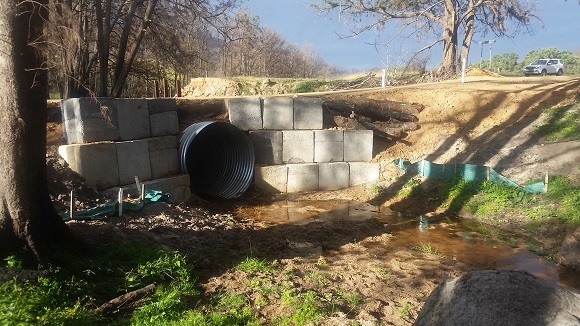

 April 2021: The concrete culverts are in place and the new road is being built above

 May 2021: The bridge replacement was opened to traffic in early May

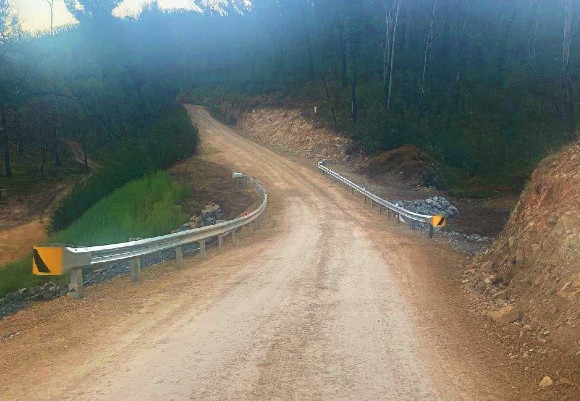

 The final product: Guardrail lines the road over the new culverts

                    Previous

                    Next

 Pre-fire: The bridge sat in a lush forest

 January 2020: The bridge abutment walls no longer exist and little is left of the deck

 January 2020: A temporary track winds around the burnt out bridge

 May 2020: The temporary side track was washed away by flood waters and later rebuilt

 March 2021: Gabion baskets are installed for the water spillway downhill from the bridge

 April 2021: The concrete culverts are in place and the new road is being built above

 May 2021: The bridge replacement was opened to traffic in early May

 The final product: Guardrail lines the road over the new culverts
